Critical Path

Project management involves multiple activities that are tightly dependent on each other. These dependencies lead to strict deadlines failing, which causes the project to fall behind schedule. Zoho Projects displays the critical path of the project, which is the longest stretch of dependent activities in a project. These activities or tasks cannot be delayed without delaying the overall project. Identifying the critical path lets you effectively devote time and resources to such tasks.
Feature Availability: Enterprise plan

Benefits

  1. Identify activities that require more focus. Delaying these activities can throw projects off track
  2. Use the critical path timeline as a benchmark and measure the actual progress against it
  3. Identify non-critical activities and economize resources
Create tasks, set the duration, and establish task dependencies. Zoho Projects gives a visual representation of the critical path on a Gantt chart. You can also view non-critical activities and their slack time by hovering over the task.

Points to Note

  1. If no dependency is set, the task that is finishing last will be shown as critical.
  2. For tasks having a dependency with no lag/lead, changing the date of predecessor task will affect the date of the successor task.
  3. For tasks have dependency with a lag/lead, changing the date of the predecessor will also maintain the lag with successor task.
  4. For tasks with multiple dependencies, the predecessor with the longest duration will be critical.

Critical Path in Zoho Projects

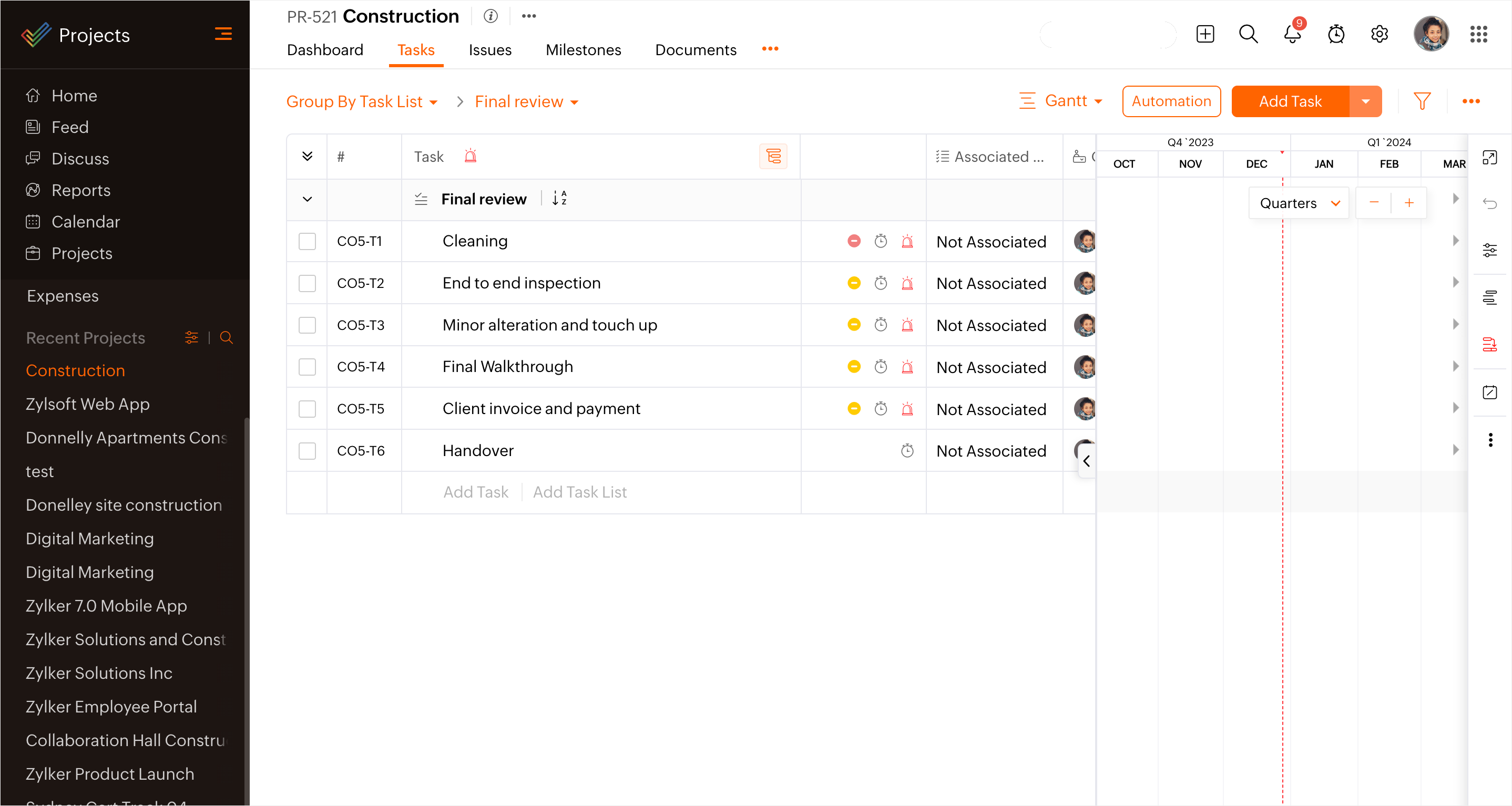

Constructing a house involves numerous tasks that are dependent on one another. Considering a broad level list of tasks, let's see how Zoho Projects displays the critical path for the below schedule.


The critical path of the project is highlighted in red. Non-critical tasks are shown in blue. The dotted line denotes the slack for non-critical tasks.

View Critical Path on Gantt Chart

View Critical Path

  1. Navigate to your project and click Tasks in the top band.
  2. Open the Gantt view.
  3. Click in the smart bar on the right.
  4. Toggle Critical Path and Slack to view them on the Gantt Chart.
  5. Critical tasks will be highlighted in the task details page even if Critical Path is toggled off.

Slack in Tasks

Slack is the acceptable delay in a task without delaying the project. Tasks that have slack are not part of the critical path and are considered non-critical activities. Slack is represented by a dotted line.

Slack in Dependent Tasks

If there a multiple successor tasks, the slack line will be shown from predecessor task to the nearest successor task.
  1. SS dependency: Slack line will be shown from the predecessor's start date to the successor's start date.
  2. SF dependency: Slack line will be shown from the predecessor's start date to the successor's end date.
  3. FS dependency: Slack line will be shown from the predecessor's end date to the successor's start date.
  4. FF dependency: Slack line will be shown from the predecessor's end date to the successor's end date.
Holidays will not be considered for charting the critical path.





        Create. Review. Publish.

        Write, edit, collaborate on, and publish documents to different content management platforms.

        Get Started Now


          Access your files securely from anywhere

            Zoho CRM Training Programs

            Learn how to use the best tools for sales force automation and better customer engagement from Zoho's implementation specialists.

            Zoho CRM Training
              Redefine the way you work
              with Zoho Workplace

                Zoho DataPrep Personalized Demo

                If you'd like a personalized walk-through of our data preparation tool, please request a demo and we'll be happy to show you how to get the best out of Zoho DataPrep.

                Zoho CRM Training

                  Create, share, and deliver

                  beautiful slides from anywhere.

                  Get Started Now


                    Zoho Sign now offers specialized one-on-one training for both administrators and developers.

                    BOOK A SESSION







                                Quick LinksWorkflow AutomationData Collection
                                Web FormsEnterpriseOnline Data Collection Tool
                                Embeddable FormsBankingBegin Data Collection
                                Interactive FormsWorkplaceData Collection App
                                CRM FormsCustomer ServiceAccessible Forms
                                Digital FormsMarketingForms for Small Business
                                HTML FormsEducationForms for Enterprise
                                Contact FormsE-commerceForms for any business
                                Lead Generation FormsHealthcareForms for Startups
                                Wordpress FormsCustomer onboardingForms for Small Business
                                No Code FormsConstructionRSVP tool for holidays
                                Free FormsTravelFeatures for Order Forms
                                Prefill FormsNon-Profit

                                Intake FormsLegal
                                Mobile App
                                Form DesignerHR
                                Mobile Forms
                                Card FormsFoodOffline Forms
                                Assign FormsPhotographyMobile Forms Features
                                Translate FormsReal EstateKiosk in Mobile Forms
                                Electronic Forms
                                Drag & drop form builder

                                Notification Emails for FormsAlternativesSecurity & Compliance
                                Holiday FormsGoogle Forms alternative GDPR
                                Form to PDFJotform alternativeHIPAA Forms
                                Email FormsFormstack alternativeEncrypted Forms

                                Wufoo alternativeSecure Forms

                                TypeformWCAG


                                      All-in-one knowledge management and training platform for your employees and customers.

                                                Create. Review. Publish.

                                                Write, edit, collaborate on, and publish documents to different content management platforms.

                                                Get Started Now




                                                                  You are currently viewing the help pages of Qntrl’s earlier version. Click here to view our latest version—Qntrl 3.0's help articles.




                                                                      Manage your brands on social media


                                                                        • Desk Community Learning Series


                                                                        • Digest


                                                                        • Functions


                                                                        • Meetups


                                                                        • Kbase


                                                                        • Resources


                                                                        • Glossary


                                                                        • Desk Marketplace


                                                                        • MVP Corner


                                                                        • Word of the Day


                                                                        • Ask the Experts


                                                                          Zoho Sheet Resources



                                                                              Zoho Forms Resources


                                                                                Secure your business
                                                                                communication with Zoho Mail


                                                                                Mail on the move with
                                                                                Zoho Mail mobile application

                                                                                  Stay on top of your schedule
                                                                                  at all times


                                                                                  Carry your calendar with you
                                                                                  Anytime, anywhere




                                                                                        Zoho Sign Resources

                                                                                          Sign, Paperless!

                                                                                          Sign and send business documents on the go!

                                                                                          Get Started Now




                                                                                                  Zoho TeamInbox Resources





                                                                                                            Zoho DataPrep Demo

                                                                                                            Get a personalized demo or POC

                                                                                                            REGISTER NOW


                                                                                                              Design. Discuss. Deliver.

                                                                                                              Create visually engaging stories with Zoho Show.

                                                                                                              Get Started Now








                                                                                                                                  • Related Articles

                                                                                                                                  • Critical Path

                                                                                                                                    What is critical path? A critical path is the longest sequence of activities in Zoho Projects. These activities have to be completed on time for a project to stay on track. Project Managers can use critical path to identify critical tasks and ...
                                                                                                                                  • Gantt Chart

                                                                                                                                    Gantt chart The Gantt chart displays a visual representation of your project schedule. It also shows information about the task progress, task owner, task status, and other task-related data. Feature availability: The Gantt chart is only supported in ...
                                                                                                                                  • Gantt chart

                                                                                                                                    Gantt Chart A Gantt chart is a visual representation of the project schedule. It displays information about task progress, the task owner, the task status, and other task-related data. Access Gantt Chart Tap the hamburger icon at the top-left corner. ...
                                                                                                                                  • Baseline

                                                                                                                                    The baseline captures the schedule deviation from the original plan. It helps you assess the actual results of the project and track its progress. Baseline is a snapshot of the original schedule. At any given point of time in a project, users can ...
                                                                                                                                  • Task Roll-Up

                                                                                                                                    Task Roll-Up in Projects Roll-Up helps you summarize project information, such as the overall project duration, planned work hours, actual log hours, and percentage completion. A project Roll-Up summarizes the total of the planned work hours of the ...
                                                                                                                                    Wherever you are is as good as
                                                                                                                                    your workplace

                                                                                                                                      Resources

                                                                                                                                      Videos

                                                                                                                                      Watch comprehensive videos on features and other important topics that will help you master Zoho CRM.



                                                                                                                                      eBooks

                                                                                                                                      Download free eBooks and access a range of topics to get deeper insight on successfully using Zoho CRM.



                                                                                                                                      Webinars

                                                                                                                                      Sign up for our webinars and learn the Zoho CRM basics, from customization to sales force automation and more.



                                                                                                                                      CRM Tips

                                                                                                                                      Make the most of Zoho CRM with these useful tips.



                                                                                                                                        Zoho Show Resources
